Case overview



Built in 1986, Riverside Centre is one of the most prestigious commercial buildings in Brisbane, Australia. When it was constructed, the building was considered ahead of its time in intelligent building technology. Thirty-one years later, its 21 lifts needed to be modernized so the building could remain at the leading edge of innovative building technology.



Project nameRiverside Centre
LocationBrisbane, Australia
Modernization completed2017
Floors41
DeveloperThe GPT Group
Vertical Transport ConsultantNorman Disney Young
ArchitectHarry Seidler & Associates

Key project requirements

  • Upgrade the elevators to meet modern commercial requirements
  • Develop solutions that support the architect’s vision
  • Limit disruption to tenants during modernization

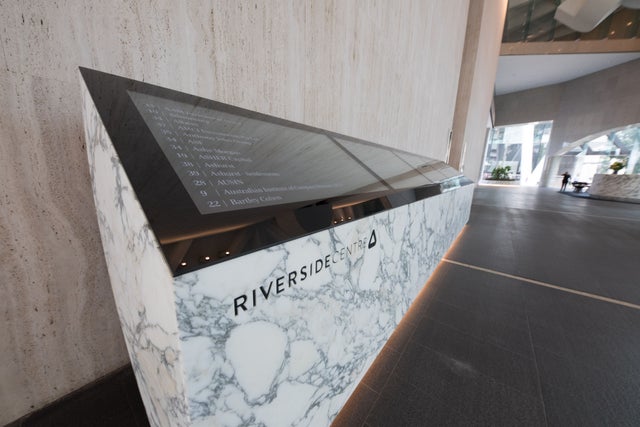

Riverside Centre touchscreen

Bespoke solutions for a Brisbane icon

The project involved the complete refurbishment of 21 elevators and the installation of the KONE Destination Control System, which predicts travel patterns to reduce overcrowding and unnecessary stops. Five large touchscreens were integrated into a custom tenancy directory, allowing guests to use the directory as another destination control panel.



The customer also wanted a unique system to alert people not to use an elevator during a fire. Instead of a typical sticker or plaque, a warning message is displayed on screen when sensors detect smoke. Special software was developed to enable the system.

“The visitor selects the tenant she wants on the interactive directory and the system tells her which lift to use.”



Chris Valentine
Modernization Project Manager, KONE

placeholder

Modernizing with minimal disruption

Delivering these upgrades while Riverside Centre remained operational required meticulous planning throughout the 2.5-year modernization. Weekly meetings between KONE and GPT supported timely communication with tenants, while disruptive work was carried out at night. Extraction fans, sealed work areas and thorough cleaning helped prepare the building for each new day, and an innovative protective platform allowed two teams to work safely in the goods-elevator shaft at the same time, reducing the installation period from 16 weeks to 11 weeks.

“Our goal was to complete the works with minimal customer-facing indicators. We wanted our customers to believe it was business as usual.”



Clint Francis
Operations Manager, Riverside Centre, GPT Group

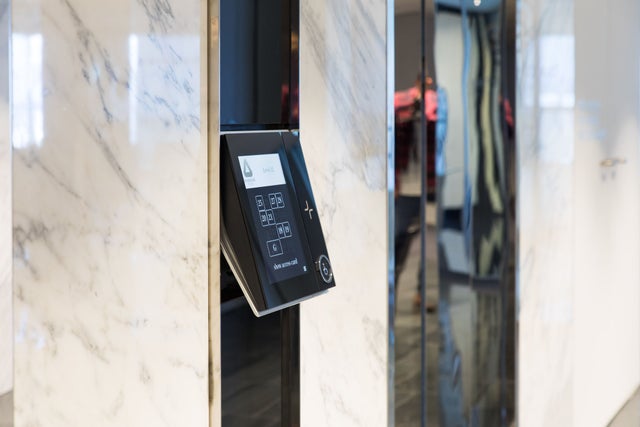

KONE Destination Control System

Results of the collaboration

Smooth people flow
The destination control system helps reduce overcrowding and unnecessary stops.



Improved energy efficiency
Following the modernization total energy savings are expected to be 30–40%.

Reduced installation time
The new approach to modernizing the goods elevator reduced the installation period from 16 weeks to 11 weeks.



Higher customer satisfaction
Following the modernization, lift-service satisfaction increased from 57 in 2014 to 73 in 2017.

KONE arrow

Technology highlights

  • 3 KONE MonoSpace® Elevators
  • 17 Regen800 Elevators
  • 1 Resolve 40 Hydro
  • KONE Destination Control System
  • MDE3000+ Overlay
  • KONE E-Link™ Monitoring System with high level output to BMS
  • Pixel Face to Face Emergency Communication
  • Lobby Directory Board Touch Destination Screens interfaced with lifts
